Gas Dehydration

Molecular Sieve Design: Adsorption Engineering Fundamentals

Design molecular sieve dehydration systems using Type 3A, 4A, and 5A zeolites with thermal swing adsorption (TSA) to achieve <0.1 ppmv outlet water for LNG and cryogenic processing.

Water Capacity

18-22 wt%

Type 4A at 77°F, saturated conditions per GPSA Fig 20-37.

Regeneration

450-550°F

Typical bed temperature for complete water desorption.

Cycle Time

8-24 hours

Standard adsorption time before switching to regeneration.

Use this guide to:

  • Select appropriate zeolite type (3A, 4A, 5A)
  • Size molecular sieve beds per GPSA
  • Design TSA regeneration cycles
  • Troubleshoot operational issues

1. Overview & Applications

Molecular sieves are synthetic crystalline aluminosilicates (zeolites) with uniform pore structures that selectively adsorb molecules based on size and polarity. For natural gas dehydration, molecular sieves achieve outlet dew points of -100°F to -150°F—far beyond glycol dehydration capabilities.

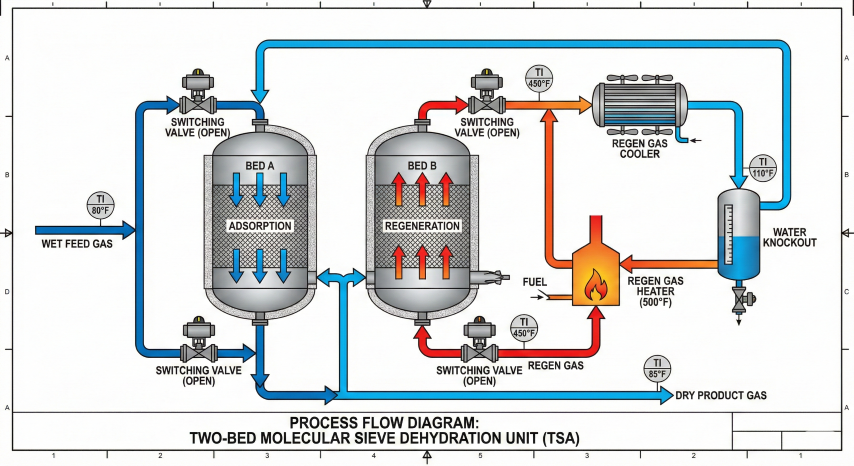

Process flow diagram of two-bed molecular sieve TSA system showing adsorption and regeneration cycles with heater, cooler, water knockout, and switching valves
Two-bed TSA system: One bed adsorbs while the other regenerates with hot gas; switching valves alternate beds between cycles.

LNG Feedstock

<0.1 ppmv H₂O

Required to prevent ice formation in cryogenic exchangers at -260°F.

NGL Recovery

-40 to -80°F Dew Point

Prevent hydrate formation in turboexpander and demethanizer.

Pipeline Spec

7 lb H₂O/MMscf

Typical spec; mol sieves easily achieve <1 lb/MMscf.

Glycol vs Mol Sieve

Glycol: -40°F max

TEG limited to ~7 lb/MMscf; mol sieves required for deeper drying.

Why molecular sieves for LNG: Glycol dehydration achieves ~7 lb H₂O/MMscf (dew point -20 to -40°F), but LNG requires <0.1 ppmv H₂O (dew point -100°F or lower) to prevent ice formation in cryogenic heat exchangers. Only molecular sieves can reach this specification economically.

2. Zeolite Type Selection

Zeolite type selection depends on feed gas composition and what contaminants (beyond water) need to be removed. The pore size determines which molecules can enter and be adsorbed.

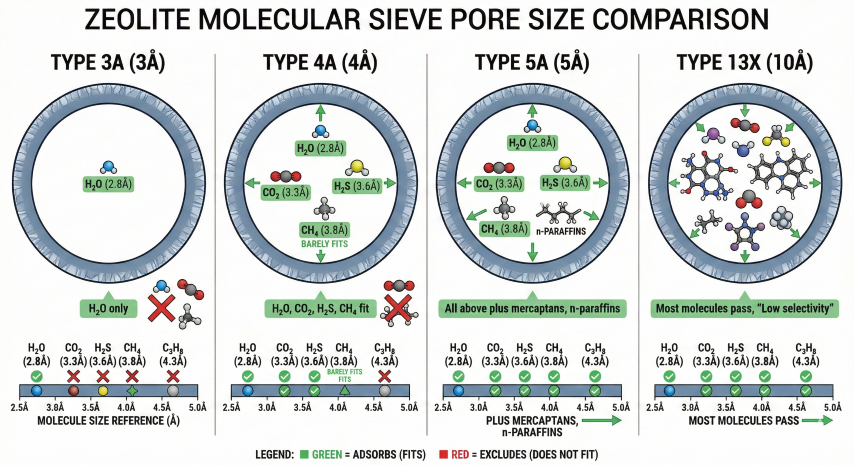

Comparison diagram of zeolite pore sizes showing Type 3A (3Å), 4A (4Å), 5A (5Å), and 13X (10Å) with molecular size references for water, CO₂, H₂S, and hydrocarbons
Zeolite pore selection: Type 3A for water-only removal; Type 4A for water + acid gas; Type 5A for mercaptans.
Type Pore (Å) Adsorbs Excludes Primary Application
3A 3 H₂O, NH₃ CO₂, H₂S, C₂+ Water-only removal; rich gas with high C₃+
4A 4 H₂O, CO₂, H₂S C₃+, aromatics Most common for NG; combined H₂O + acid gas
5A 5 H₂O, CO₂, H₂S, mercaptans iso-paraffins, C₅+ Sour gas with mercaptans; high water loading
13X 10 H₂O, CO₂, H₂S, all HC Large molecules Bulk acid gas removal; less selective

Selection Guidelines

  • Type 3A: Use when inlet gas has high C₃+ content and you want water removal ONLY. Prevents hydrocarbon co-adsorption that would contaminate regeneration gas and reduce bed life.
  • Type 4A: Standard choice for most natural gas applications. Removes water + CO₂ + H₂S simultaneously. Most cost-effective for sweet to moderately sour gas.
  • Type 5A: Required when mercaptans (RSH) must be removed along with water. Higher capacity than 4A but co-adsorbs more hydrocarbons.
  • Type 13X: Use for bulk CO₂ removal upstream of a 4A polishing bed. Not recommended as primary dehydration sieve due to low selectivity.

Physical Properties

Property 3A 4A 5A 13X
Bulk density (lb/ft³) 43 42 41 40
Water capacity @ 77°F (wt%) 20 22 21.5 28
Bead size (mesh) 8×12 8×12 8×12 8×12
Max regen temp (°F) 600 600 600 600
Heat capacity (Btu/lb·°F) 0.22 0.22 0.22 0.23

3. Adsorption Fundamentals

Molecular sieve adsorption is driven by strong electrostatic interaction between polar water molecules and the ionic framework of the zeolite. The adsorption is highly exothermic, releasing ~1800 Btu/lb water adsorbed.

Dynamic Capacity

Design capacity is less than equilibrium capacity due to temperature effects, relative saturation, and safety factors. GPSA Figure 20-37 provides capacity correction curves.

Dynamic Capacity Calculation: Capacity_design = Capacity_base × F_T × F_sat × F_util Where: • Capacity_base = 20-22 wt% for Type 4A at 77°F, saturated • F_T = Temperature correction factor - F_T = 1.0 - 0.004 × (T - 77) for T > 77°F - At 100°F: F_T = 0.91 - At 150°F: F_T = 0.71 • F_sat = Relative saturation correction - At 100% RS: F_sat = 1.0 - At 50% RS: F_sat ≈ 0.85 - At 10% RS: F_sat ≈ 0.60 • F_util = Design utilization factor = 0.60-0.80 - Accounts for non-uniform flow and aging - Conservative design: use 0.70 Example: Type 4A at 100°F, saturated gas, 70% utilization Capacity_design = 22% × 0.91 × 1.0 × 0.70 = 14.0 wt%

Mass Transfer Zone (MTZ)

The MTZ is the region of the bed where water concentration transitions from saturated (inlet) to fresh (outlet) sieve. Bed height must exceed 2-3× MTZ length to prevent premature breakthrough.

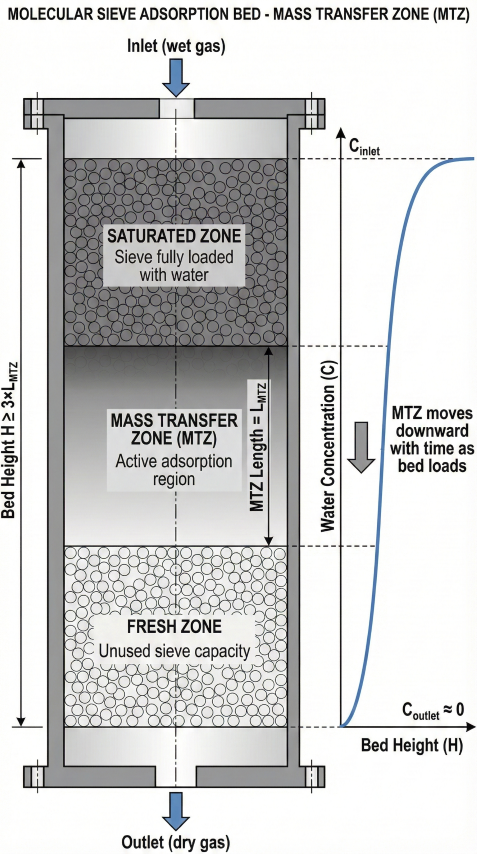

Vertical cross-section of molecular sieve bed showing saturated zone, mass transfer zone (MTZ), and fresh zone with concentration profile S-curve
Mass transfer zone: Active adsorption front moves down through bed; bed height must exceed 3× MTZ length to prevent breakthrough.
MTZ Length Estimation: L_MTZ = v_front × t_MTZ Where: • L_MTZ = MTZ length (ft) • v_front = Saturation wave (front) velocity (ft/min) - v_front = (Q × C_in) / (A × ρ_bulk × X_dyn) - Typically 0.05-0.5 ft/min (much slower than gas velocity) • t_MTZ = MTZ formation time (minutes) - Typically 30-300 minutes for gas dehydration - Increases with velocity and water content Design requirement: • Bed height H ≥ 3 × L_MTZ for reliable operation • H ≥ 2 × L_MTZ is marginal (close monitoring needed) Breakthrough time: t_breakthrough = Cycle_time × (H/L_MTZ - 1) / (H/L_MTZ) At H = 3×L_MTZ: Safe time = 67% of cycle time

Co-Adsorption Effects

Type 4A and 5A sieves co-adsorb other components, which reduces water capacity and complicates regeneration.

Component 3A 4A 5A Impact
CO₂ No Yes (~10%) Yes (~12%) Reduces H₂O capacity 2-5%
H₂S No Yes (~6%) Yes (~8%) Difficult to regenerate; fouls bed
Mercaptans No Partial Yes Irreversible adsorption; poisons bed
Heavy HC (C₆+) No No Partial Deposits in pores; use 3A if high C₆+
Sour gas considerations: For gas with >100 ppmv H₂S, either use Type 3A (excludes H₂S) or install upstream amine treating. H₂S adsorbs strongly on Type 4A and is difficult to fully desorb, leading to gradual capacity loss.

4. Bed Sizing Method

Bed sizing involves calculating required sieve mass from water loading, then determining vessel dimensions from velocity constraints and volume requirements.

Step 1: Water Loading per Cycle

Water Loading Calculation: W_cycle = Q × (C_in - C_out) × t_ads × F_upset / 24 Where: • W_cycle = Water to be adsorbed per cycle (lb) • Q = Gas flow rate (MMscfd) • C_in = Inlet water content (lb/MMscf) • C_out = Target outlet water (lb/MMscf) • t_ads = Adsorption cycle time (hours) • F_upset = Upset factor (1.15-1.25 for flow variations) Example: Q = 100 MMscfd, C_in = 60 lb/MMscf, C_out = 1 lb/MMscf t_ads = 16 hours, F_upset = 1.15 W_cycle = 100 × (60-1) × 16 × 1.15 / 24 W_cycle = 4,523 lb water/cycle

Step 2: Required Sieve Mass

Sieve Mass Calculation: M_sieve = W_cycle / Capacity_design Using example above with Capacity_design = 14% = 0.14: M_sieve = 4,523 / 0.14 = 32,310 lb per bed Bed volume: V_bed = M_sieve / ρ_bulk = 32,310 / 42 = 769 ft³

Step 3: Vessel Diameter from Velocity

Diameter Calculation: Convert flow to ACFM at operating conditions: Q_acfm = Q_scfm × (P_std/P_op) × (T_op/T_std) × Z Cross-sectional area from velocity limit: A = Q_acfm / v_s Where v_s ≤ V_max = C/√ρ_gas per GPSA (C ≈ 60 for 1/8-in beads; ~30-40 ft/min at pipeline pressure) Diameter: D = √(4A / π) Example: 100 MMscfd at 800 psig, 100°F Q_scfm = 100×10⁶/(24×60) = 69,444 scfm Q_acfm = 69,444 × (14.7/814.7) × (560/520) × 0.85 Q_acfm = 1,147 acfm At V_max = 60/√ρ = 60/√2.9 ≈ 35 ft/min: A = 1,147/35 = 32.8 ft² D = √(4×32.8/3.14) = 6.5 ft

Step 4: Bed Height and H/D Ratio

Height Calculation: H = V_bed / A = 769 / 19.5 = 39.4 ft H/D ratio = 39.4 / 5.0 = 7.9:1 ← TOO HIGH! Target H/D = 2:1 to 4:1 for good flow distribution Solution: Increase diameter or use parallel beds If D = 8 ft: A = 50.3 ft², H = 769/50.3 = 15.3 ft H/D = 15.3/8 = 1.9:1 ← Acceptable Verify MTZ: If L_MTZ = 3 ft, then H/L_MTZ = 5.1× ✓

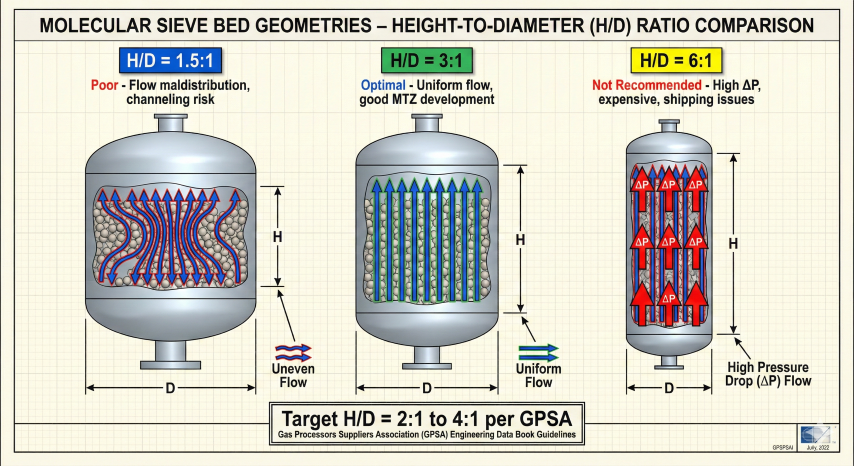

Comparison of three molecular sieve bed geometries showing H/D ratios of 1.5:1 (poor), 3:1 (optimal), and 6:1 (not recommended) with flow patterns
Bed geometry: Target H/D ratio of 2:1 to 4:1 for uniform flow distribution and reasonable pressure drop.

Pressure Drop

Pressure drop through packed beds is calculated using the Ergun equation. Design ΔP typically ranges from 5-15 psi.

Ergun Equation: ΔP/L = [150μ(1-ε)²v / (ε³dp²)] + [1.75ρ(1-ε)v² / (ε³dp)] ↑ Viscous term ↑ Inertial term Where: • ΔP/L = Pressure gradient (psi/ft) • μ = Gas viscosity (~0.0001 lb/ft·s) • ε = Bed voidage (0.37 for beads) • v = Superficial velocity (ft/s) • dp = Particle diameter (0.0066 ft for 8×12 mesh) • ρ = Gas density (lb/ft³) Typical result: 0.3-1.0 psi/ft for natural gas For H = 15 ft bed: ΔP = 5-15 psi

5. TSA Regeneration Cycle

Thermal Swing Adsorption (TSA) regenerates molecular sieves by heating to 450-550°F with dry regeneration gas, desorbing water vapor. The complete cycle includes depressurization, heating, cooling, and repressurization.

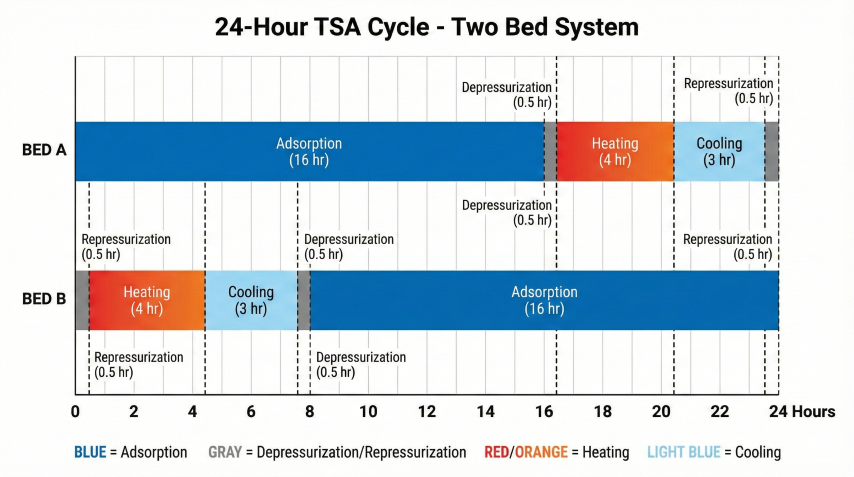

Gantt chart showing 24-hour TSA cycle timing for two-bed molecular sieve system with adsorption, depressurization, heating, cooling, and repressurization phases
TSA cycle timing: Beds alternate between 16-hour adsorption and 8-hour regeneration; one bed always on-stream.

Cycle Steps

Step Duration Conditions Purpose
1. Adsorption 8-24 hr Process P&T; gas flows down Remove water from feed gas
2. Depressurization 0.5 hr Vent to flare/recovery Reduce P for regen; recover inventory
3. Heating 3-5 hr 450-550°F regen gas; flow up Desorb water from sieve
4. Cooling 2-4 hr Ambient dry gas; flow up Cool bed to <150°F for adsorption
5. Repressurization 0.5 hr Dry product gas Equalize with operating bed

Regeneration Gas Requirements

Heat Duty Calculation: Q_total = (Q_sieve + Q_water) × F_loss Q_sieve = M_sieve × Cp × ΔT = 32,310 lb × 0.22 Btu/lb·°F × 400°F = 2.84 MMBtu Q_water = W_cycle × H_des = 4,523 lb × 1800 Btu/lb = 8.14 MMBtu F_loss = 1.20 (20% heat losses) Q_total = (2.84 + 8.14) × 1.20 = 13.2 MMBtu/cycle Regen gas flow (at 400°F rise, 4 hr heating): m_regen = Q_total / (Cp × ΔT × t) = 13.2×10⁶ / (0.5 × 400 × 4) = 16,500 lb/hr = 275 lb/min Volume flow ≈ 5,500 scfm (10-15% of feed)

Temperature Limits

Critical: Do NOT exceed 600°F (315°C) bed temperature. Higher temperatures cause sintering of the zeolite structure, resulting in permanent capacity loss and bead degradation. Control heater outlet and monitor multiple bed thermocouples.

Multi-Bed Configurations

Configuration Beds Mode Best For
Two-bed 2 1 ads, 1 regen Simple, low cost; long cycles (16-24 hr)
Three-bed 3 2 ads, 1 regen Smaller beds; short cycles (8-12 hr)
Four-bed 4 2-3 ads, 1 regen Large plants; redundancy; maintenance flexibility

6. Operations & Troubleshooting

Monitoring Parameters

  • Outlet dew point: Primary indicator of bed performance; alarm if rises above target
  • Bed temperatures: Install 6-12 thermocouples at different heights; monitor during regen
  • Pressure drop: Track over time; increase indicates fouling or fines migration
  • Regeneration gas temperature: Ensure reaching 450-550°F throughout bed

Common Problems

Problem Symptoms Likely Cause Solution
Premature breakthrough Water in product before cycle end Incomplete regen; channeling; fouling Increase regen temp/time; inspect bed
High ΔP ΔP > 20 psi; compressor issues Fines migration; liquid carryover Install upstream filters; knock out liquids
Reduced capacity Shorter cycle times over months Bed aging; irreversible adsorption High-temp regen; plan bed replacement
Bed dusting Fines in downstream equipment Thermal stress; mechanical damage Limit regen rate; install outlet screen

Bed Life Expectations

Expected service life depends on operating severity:

  • Clean, sweet gas: 5-7 years
  • Moderately sour gas: 4-5 years
  • Heavy HC or mercaptans: 3-4 years
  • High cycling or upsets: 2-4 years

Replace when capacity drops below 80% of design or when mechanical issues (dusting, high ΔP) develop.

Operational tip: Avoid liquid carryover to molecular sieve beds at all costs. Free liquids cause massive local heating during adsorption (due to concentrated heat of adsorption), leading to thermal shock, bead fracture, and rapid bed degradation. Install effective inlet separators and knockout drums.
