Foundation Design

Concrete Volume Calculations

Calculate concrete quantities for equipment foundations, pipe supports, and tank pads. Covers volume formulas, material ordering, and reinforcement per ACI 318.

Unit conversion

27 ft³ = 1 yd³

Concrete ordered in cubic yards.

Typical strength

3000–4000 psi

Standard foundation concrete.

Waste factor

+5–20%

Varies by application type.

1. Overview

Accurate volume calculations ensure correct material ordering and prevent costly mid-pour shortages. Concrete is ordered in cubic yards (US) or cubic meters (metric).

Equipment pads

Compressors, pumps

Reinforced pads for dynamic loads.

Tank foundations

Ring walls, full pads

Support storage tanks.

Pipe supports

Piers, pedestals

Drilled shafts for pipelines.

Building slabs

Control rooms

Floor slabs for structures.

Units and Conversions

Volume: 1 yd³ = 27 ft³ = 46,656 in³ 1 m³ = 35.31 ft³ = 1.308 yd³ Density: Normal weight concrete: 150 lb/ft³ (2,400 kg/m³) Lightweight concrete: 110 lb/ft³ (1,760 kg/m³) Ready-Mix Trucks: Typical capacity: 10 yd³ per truck Minimum order: 1–2 yd³ (short load fees apply)

Waste Factors

Application Factor Reason
Formed walls+5–10%Precise forms
Slab on grade+10–15%Subgrade variation
Drilled piers+15–20%Over-drilling
Complex shapes+15–20%Irregular geometry
Critical: Always order 5–10% extra. Running short creates cold joints that weaken the structure.

2. Volume Formulas

Break complex shapes into simple geometries, calculate each, then sum. Always convert to cubic yards for ordering.

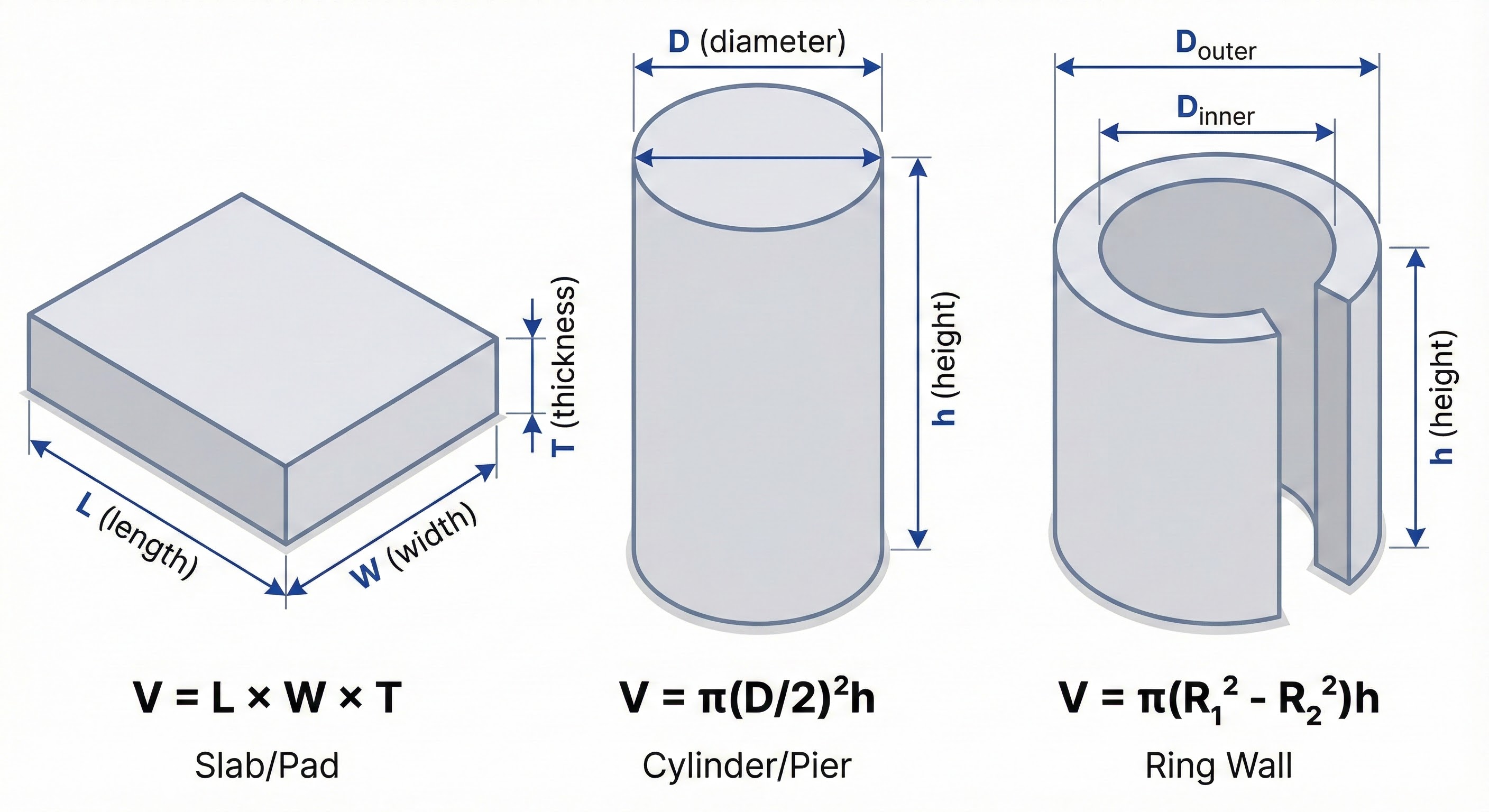

Isometric views of slab, cylinder, and ring wall with dimension labels
Isometric views of slab, cylinder, and ring wall with dimension labels.

Rectangular Slab

V = L × W × T Example: 20 ft × 15 ft × 18 in slab T = 18 ÷ 12 = 1.5 ft V = 20 × 15 × 1.5 = 450 ft³ V = 450 ÷ 27 = 16.7 yd³ Order (10% waste): 19 yd³

Cylinder (Pier)

V = π × (D/2)² × h = 0.7854 × D² × h Example: 24 in dia × 10 ft deep pier D = 24 ÷ 12 = 2 ft V = 0.7854 × 4 × 10 = 31.4 ft³ = 1.16 yd³/pier 12 piers with 20% waste: 12 × 1.16 × 1.20 = 16.7 yd³

Ring Wall (Hollow Cylinder)

V = π × (R_outer² − R_inner²) × h Example: 40 ft OD, 38 ft ID, 3 ft tall R_o = 20 ft, R_i = 19 ft V = π × (400 − 361) × 3 = 367.6 ft³ = 13.6 yd³

Footing with Wall

V_total = V_base + V_wall Example: 50 ft footing Base: 3 ft × 1 ft, Wall: 1 ft × 2 ft V_base = 50 × 3 × 1 = 150 ft³ V_wall = 50 × 1 × 2 = 100 ft³ V_total = 250 ft³ = 9.3 yd³

Formula Summary

ShapeFormula
RectangleV = L × W × T
CylinderV = π r² h
Ring wallV = π (R₁² − R₂²) h
Triangle prismV = ½ b h L

3. Equipment Foundations

Foundation size depends on equipment weight, soil capacity, and vibration requirements.

Cross-section of equipment on foundation showing load distribution to soil
Cross-section of equipment on foundation showing load distribution to soil.

Sizing Criteria

Required Area: A = W_total ÷ (q_allow × SF) Typical Thicknesses: Small pumps: 12–18 in Compressors: 24–36 in Reciprocating: 36–48 in (vibration mass) Rule of thumb: Foundation weight ≥ 2–3× equipment weight for vibrating equipment

Design Example

Compressor Foundation: Equipment: 75,000 lb total Soil: 2,000 psf, SF = 2.5 Foundation: 21 × 16 × 2.5 ft Foundation wt: 21 × 16 × 2.5 × 150 = 126,000 lb Total: 75,000 + 126,000 = 201,000 lb Pressure: 201,000 ÷ 336 = 598 psf SF check: 2,000 ÷ 598 = 3.3 ✓ Volume: 21 × 16 × 2.5 = 840 ft³ = 31.1 yd³ Order (10%): 35 yd³

Tank Foundations

Tank SizeFoundation TypeConcrete
< 20 ft diaFull pad, 6–12 in1–5 yd³
20–50 ft diaRing wall + fill5–20 yd³
> 50 ft diaRing wall20–100 yd³

Pipe Support Piers

Typical Sizes: 4–12 in pipe: 12–18 in dia × 4–6 ft deep (0.3–1.0 yd³/pier) 16–36 in pipe: 24–36 in dia × 6–8 ft deep (1–4 yd³/pier) Example: 20 in pipeline, 1,000 ft, 25 ft spacing Piers: 1,000 ÷ 25 = 40 piers Each: 24 in dia × 6 ft = 1.16 yd³ Total: 40 × 1.16 × 1.20 = 56 yd³

4. Reinforcement

Rebar provides tensile strength and crack control. Quantities estimated from steel ratios or bar schedules.

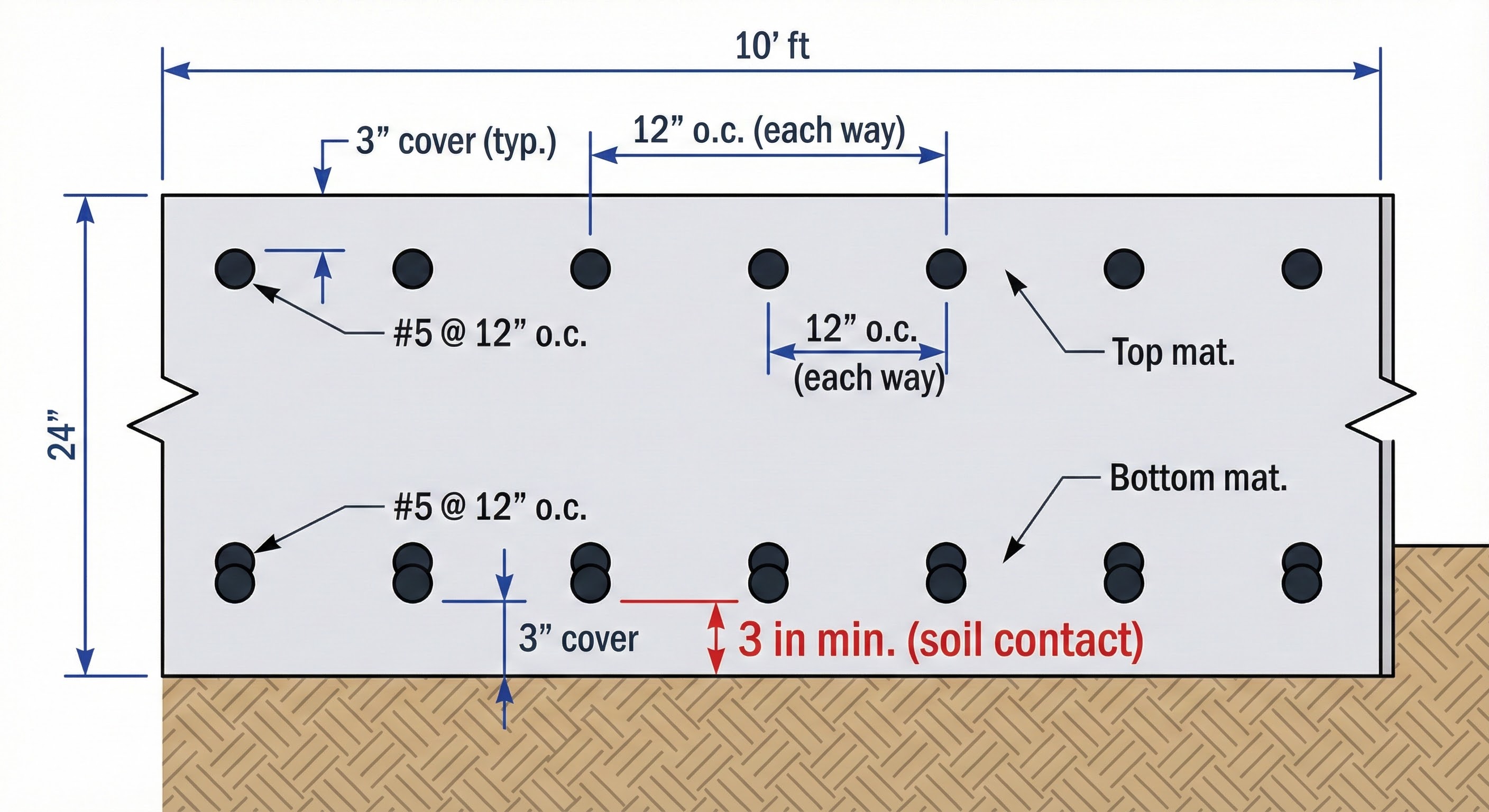

Foundation cross-section showing top/bottom rebar mats with cover dimensions
Foundation cross-section showing top/bottom rebar mats with cover dimensions.

Reinforcement Ratios

Steel Ratios (% of concrete volume): Light: 0.15–0.30% Moderate: 0.50–1.0% Heavy: 1.0–2.0% ACI 318 minimum: ρ_min = 0.0018 (Grade 60) Example: Foundation: 30 × 20 × 2 ft = 1,200 ft³ Steel ratio: 1.0% Steel volume: 12 ft³ Steel weight: 12 × 490 = 5,880 lb ≈ 3 tons

Rebar Sizes

BarDia (in)Weight (lb/ft)Area (in²)
#30.3750.3760.11
#40.5000.6680.20
#50.6251.0430.31
#60.7501.5020.44
#70.8752.0440.60
#81.0002.6700.79

Concrete Mix Specifications

StrengthApplication
3,000 psiLight-duty, non-structural
4,000 psiStandard foundations
5,000 psiHeavy equipment, high loads
6,000+ psiSpecial applications
Cover requirements: 3 in minimum for soil contact, 2 in for formed surfaces, 1.5 in for interior exposure.

5. Field Practices

Pre-Pour Checklist

  • Verify formwork dimensions match drawings
  • Check rebar size, spacing, cover, and lap splices
  • Confirm anchor bolt locations and projections
  • Ensure subgrade is compacted and not frozen
  • Coordinate truck arrival schedule

Temperature Requirements

ConditionRequirement
Cold weather (< 40°F)Heat materials, insulate, maintain 50°F min for 3–7 days
Hot weather (> 85°F)Cool mix, add retarder, max 90°F at placement
NormalBegin curing immediately, maintain moist 7 days

Common Issues

ProblemCausePrevention
CrackingShrinkage, poor curingControl joints, proper curing
HoneycombPoor vibrationProper consolidation
Cold jointsPour delayContinuous placement
ScalingFreeze-thawAir entrainment
Curing: Concrete must stay moist for 7 days minimum to reach design strength. Use curing compound, wet burlap, or plastic sheeting. Equipment installation typically waits 7 days (70% strength) or 28 days (full strength).
